Dear Candela Community,
It’s our pleasure to share the latest quarterly update from the Candela construction site as we continue to make solid progress. We appreciate your continued support and would like to keep you informed of our developments.
As of the end of September 2025, approximately 38.77% of the construction works have been completed, marking an important milestone as we move forward with the project. The following updates highlight the current status and ongoing efforts:

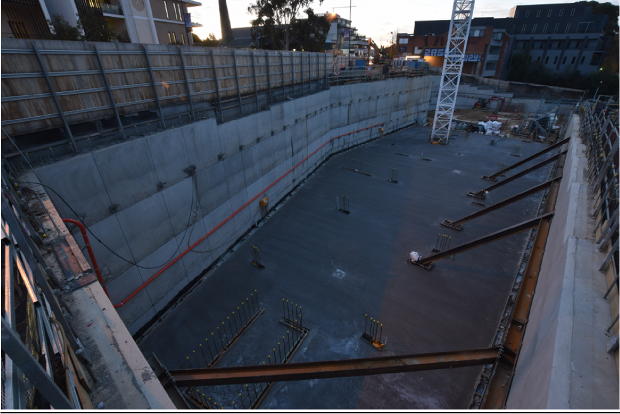

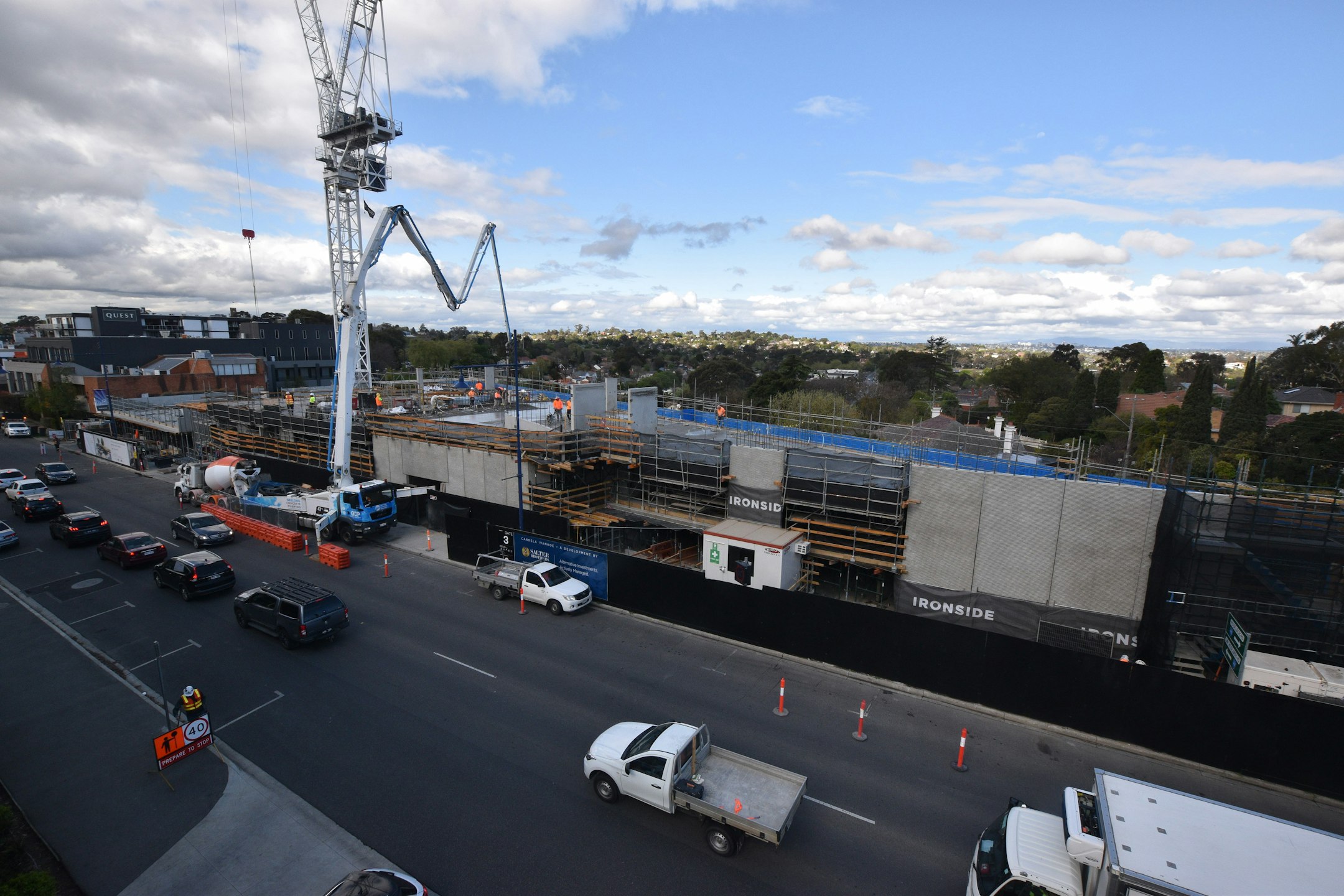

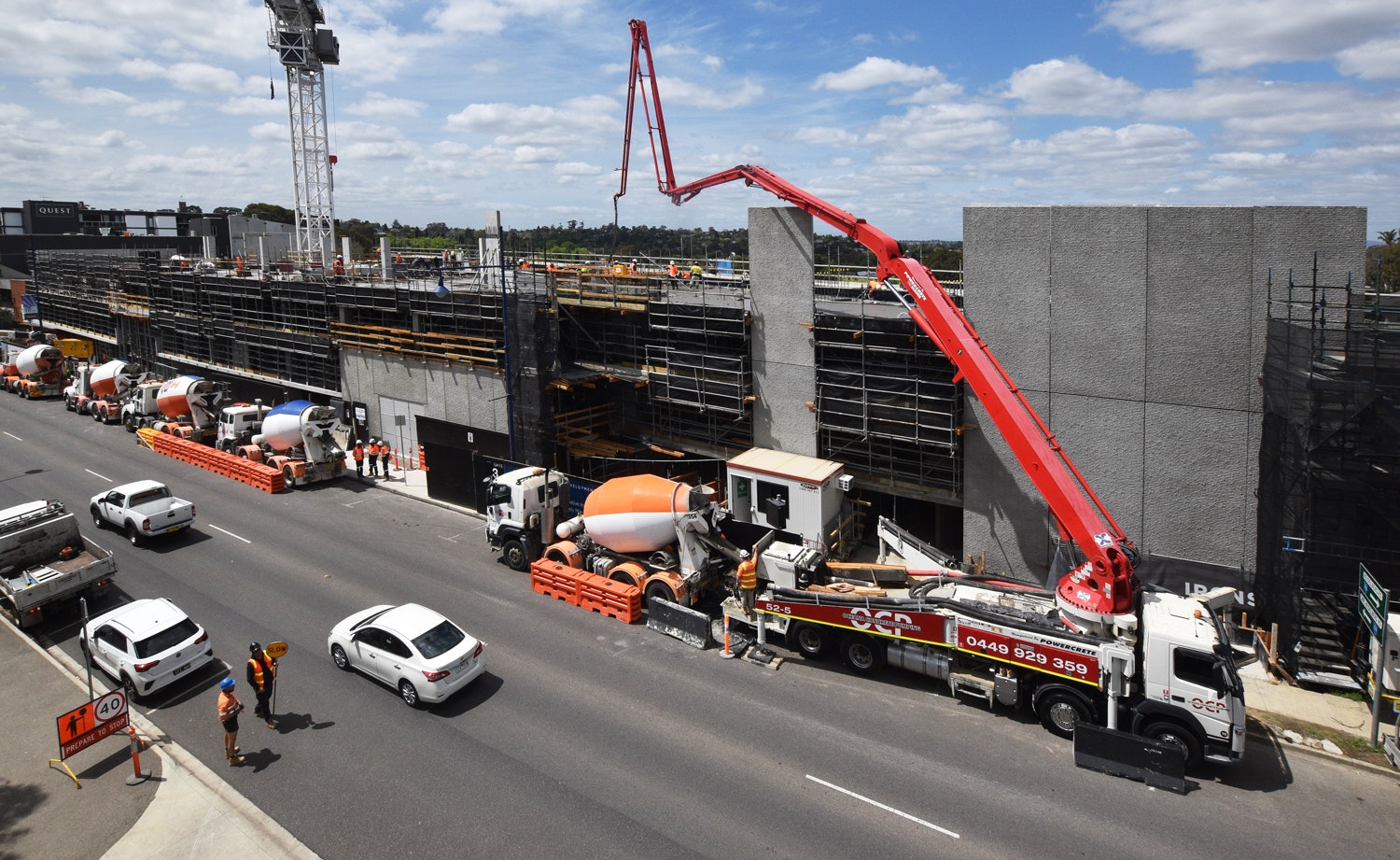

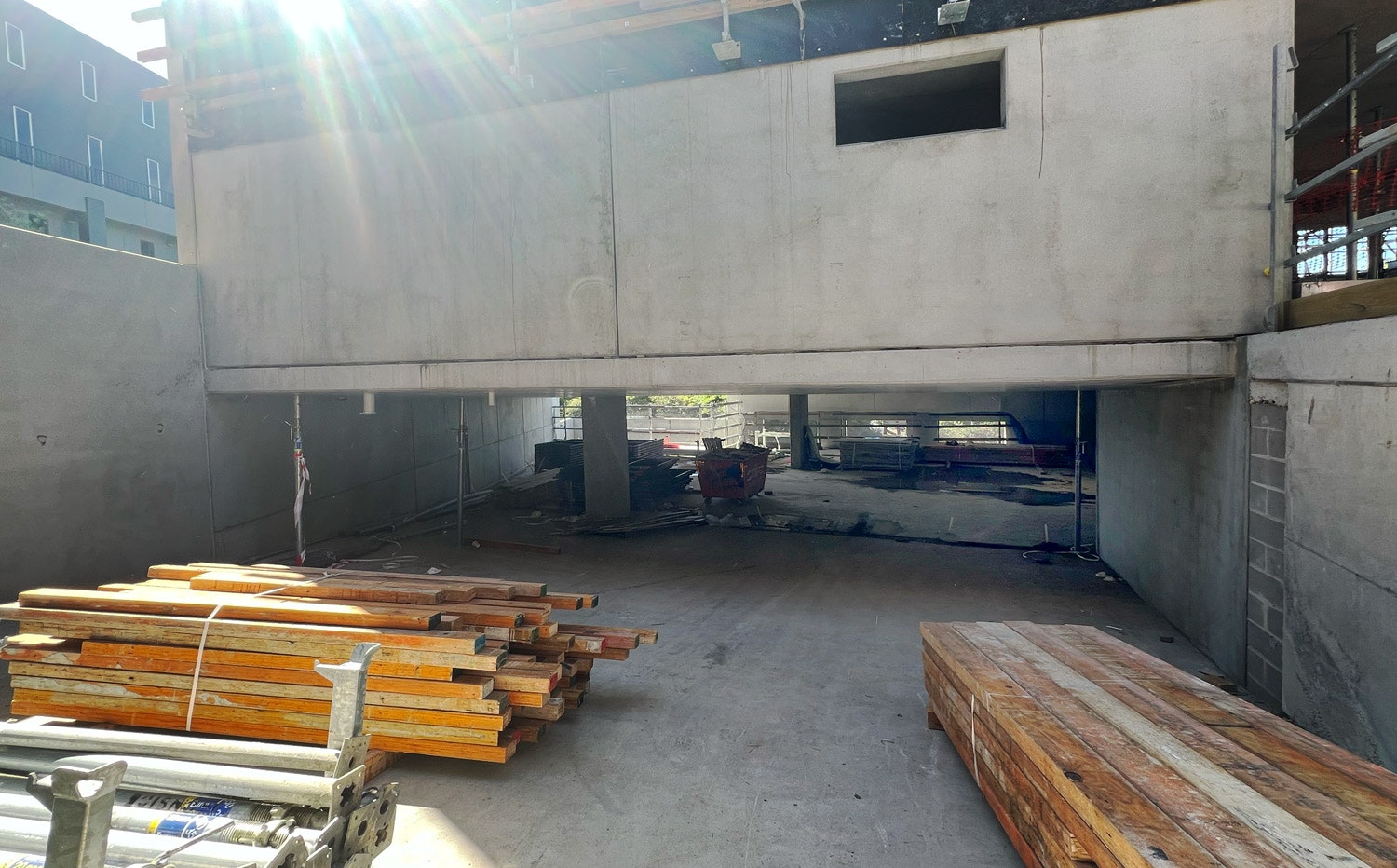

- The third and final section of the ground floor suspended concrete slab has been poured and the carpark entry ramp is now complete.

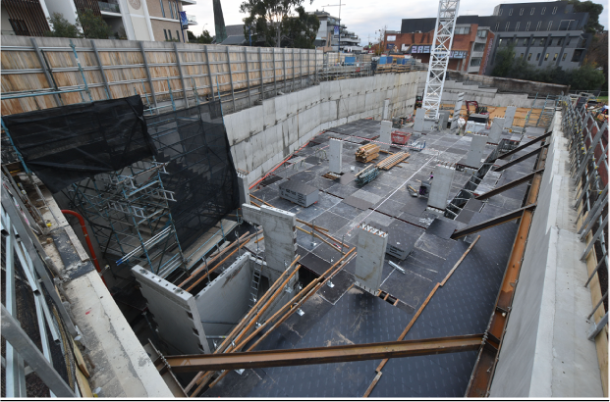

- Level 1 concrete pours 1, 2 & 3 complete.
- Level 1 precast walls & columns have been installed.

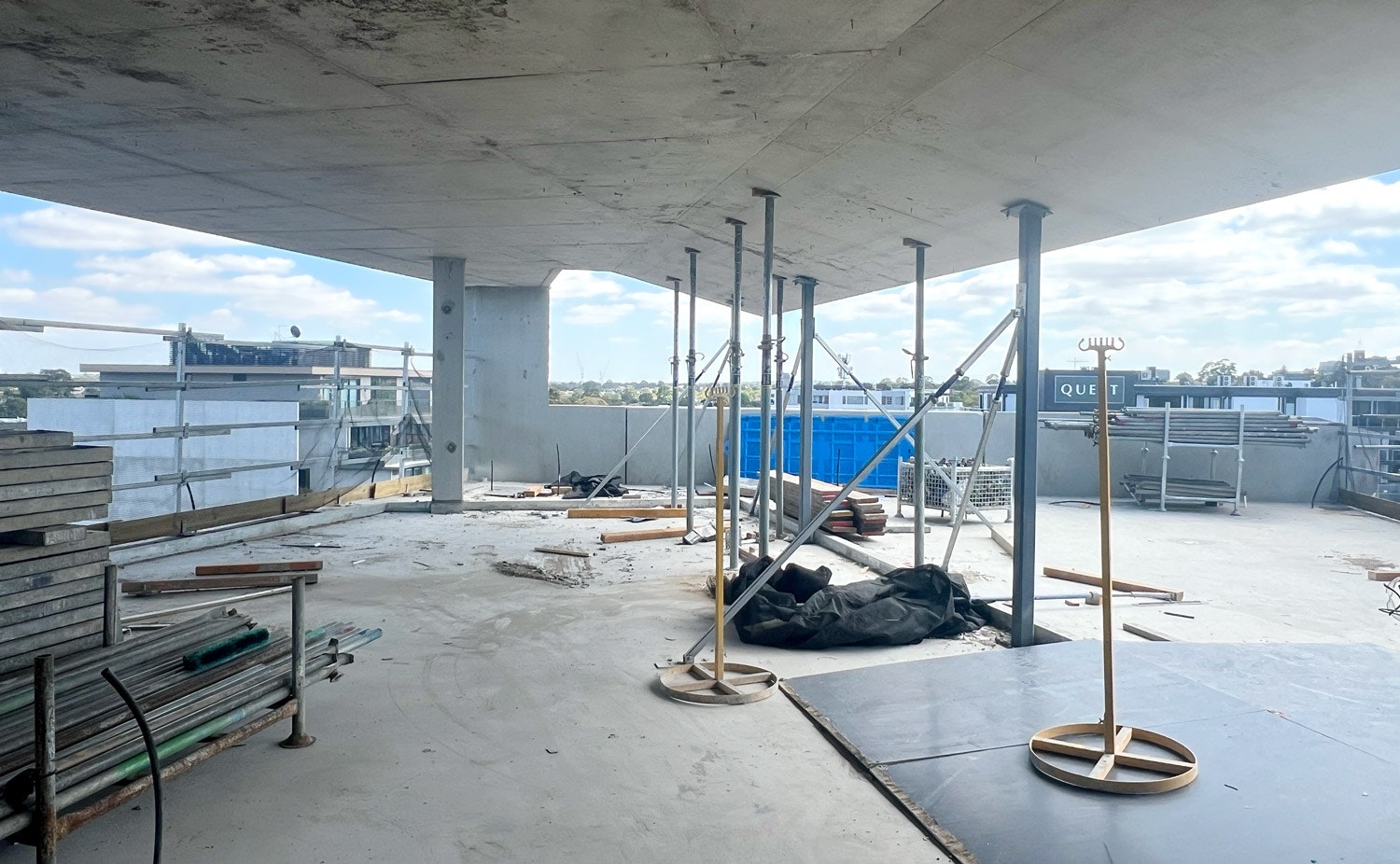

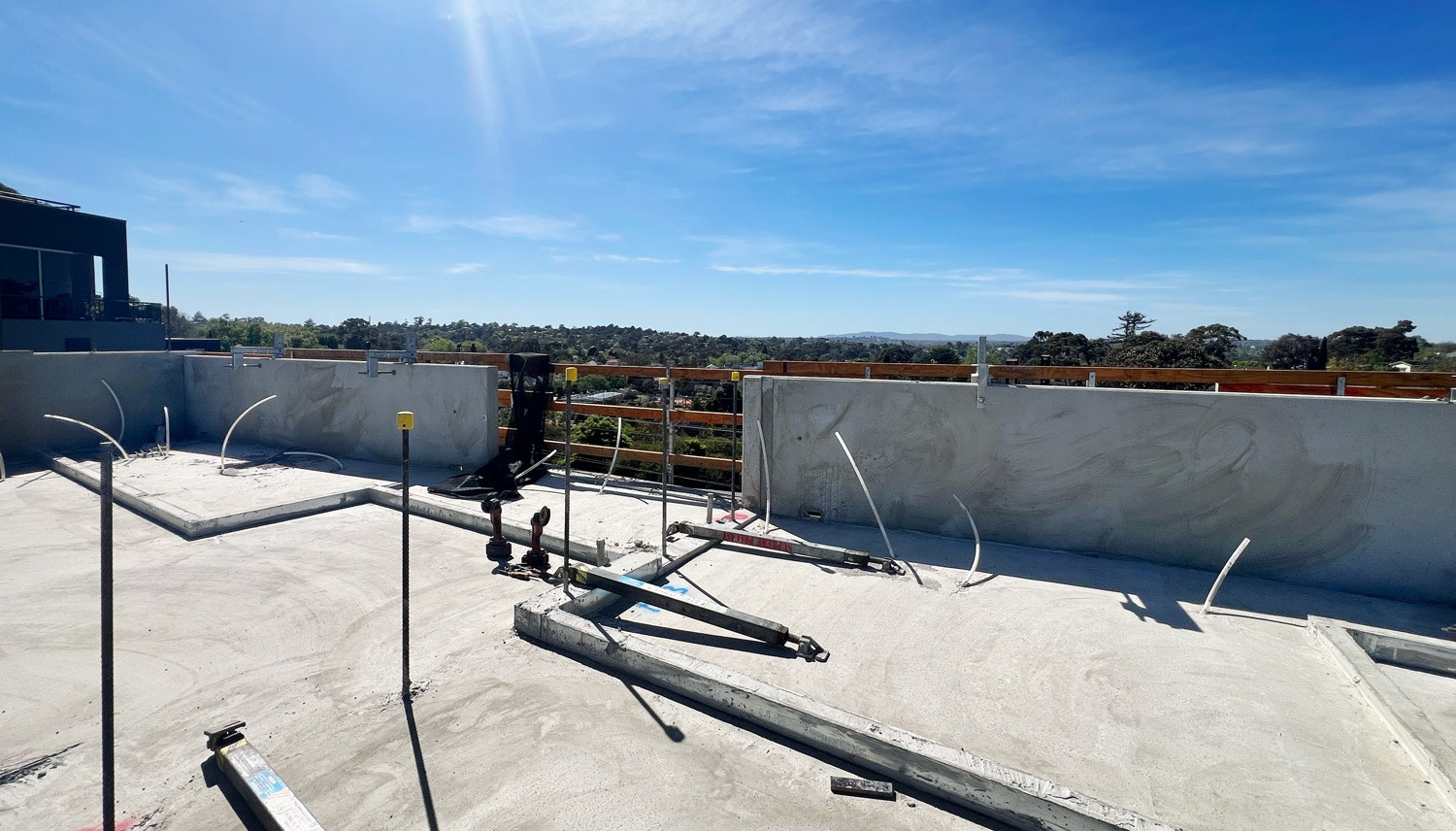

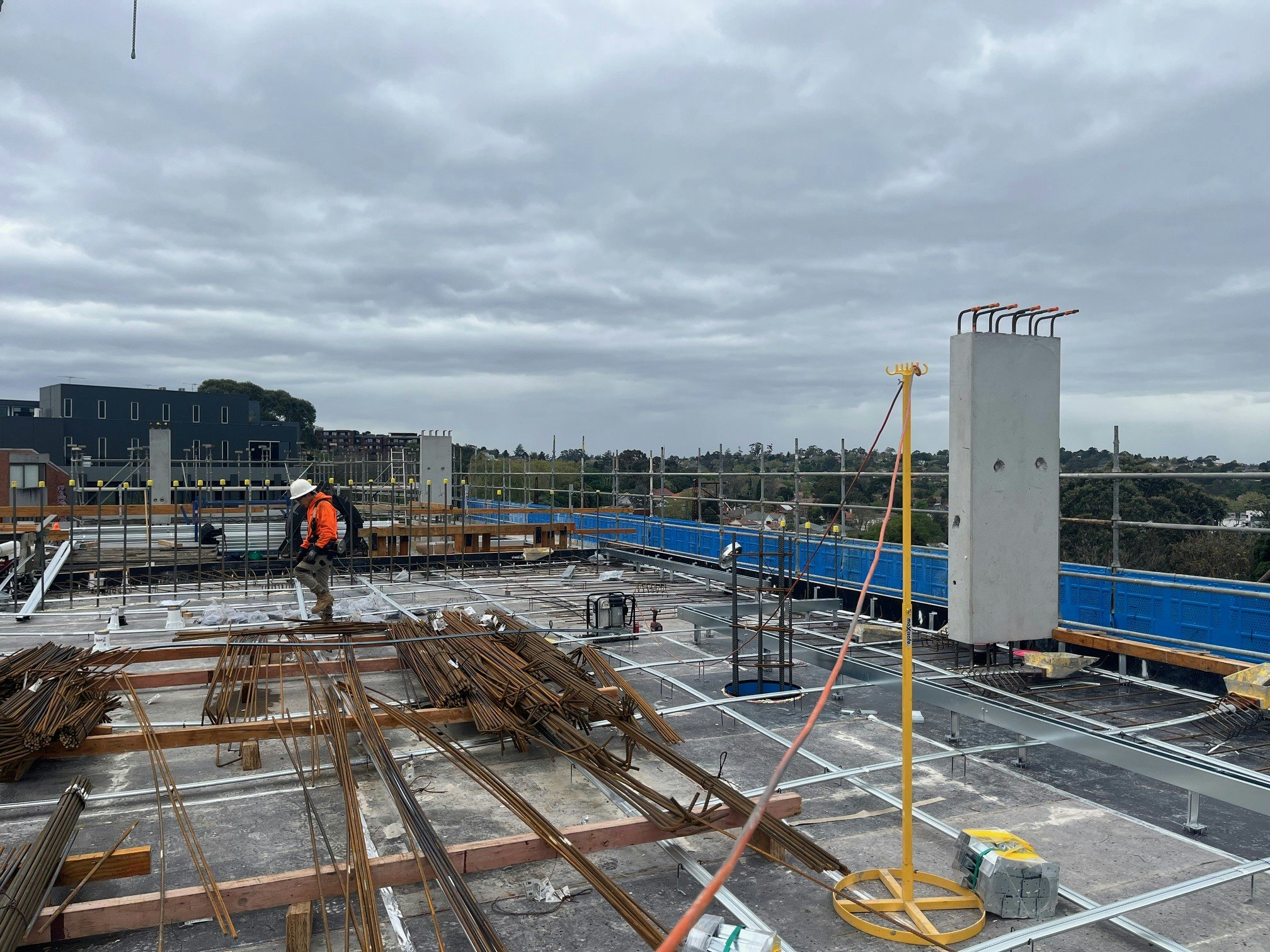

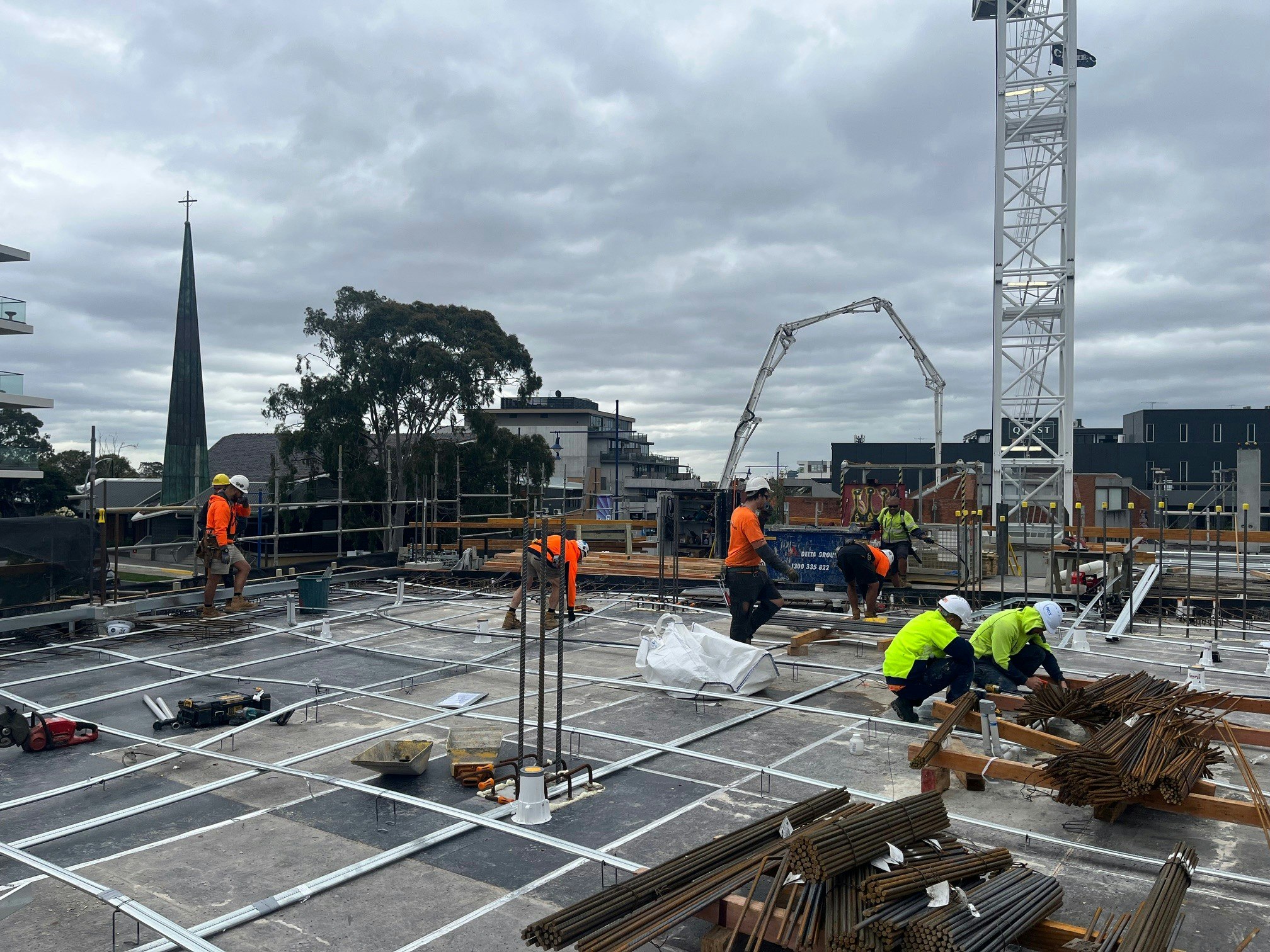

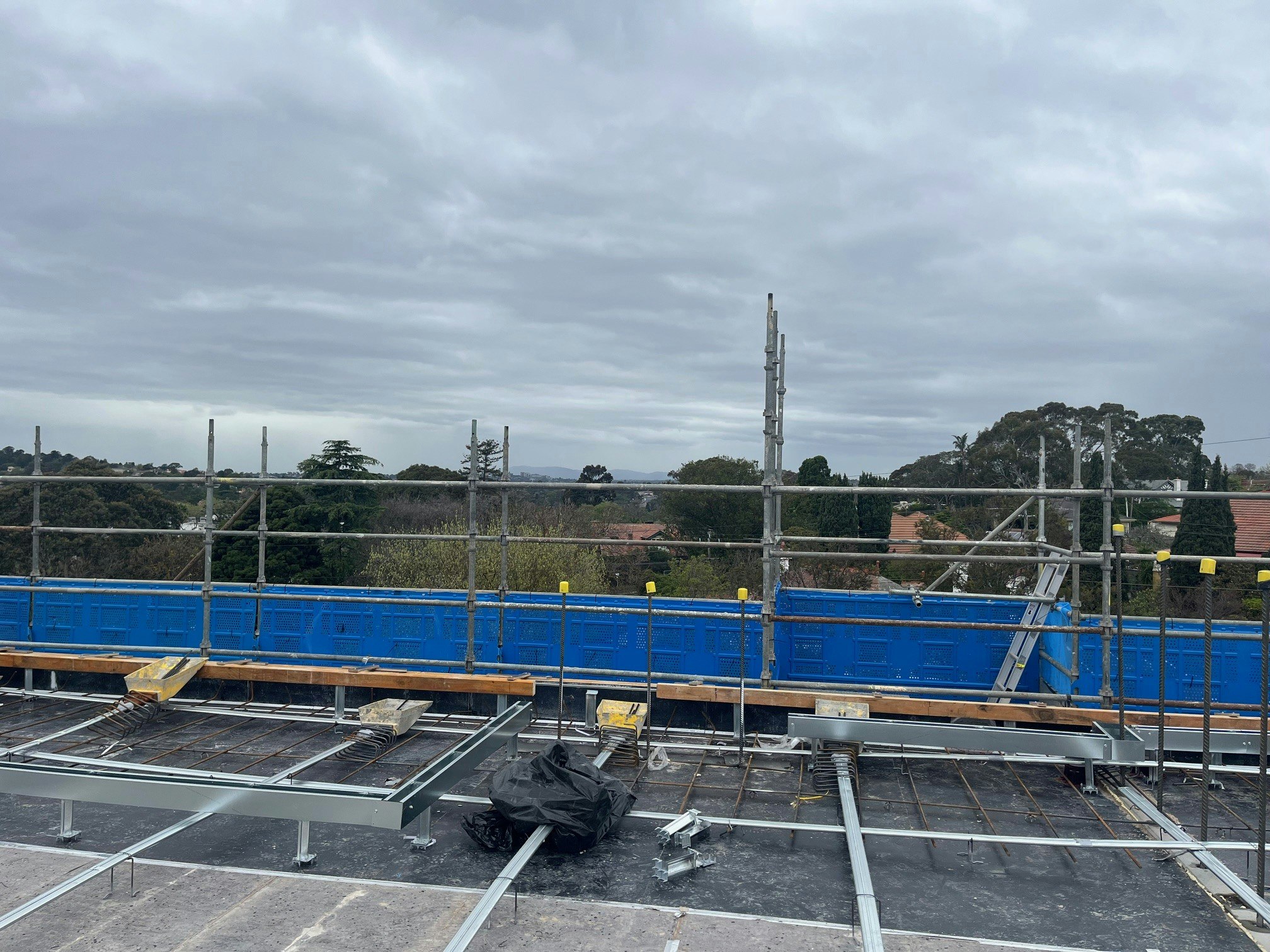

- Level 2 concrete pour 1 is now complete and the formwork has been erected for concrete pour 2.
- The feature precast concrete panels have been installed to the West façade and around the substation room on Level 2.

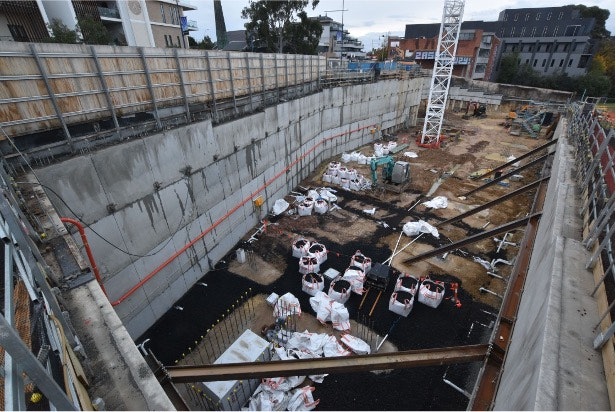

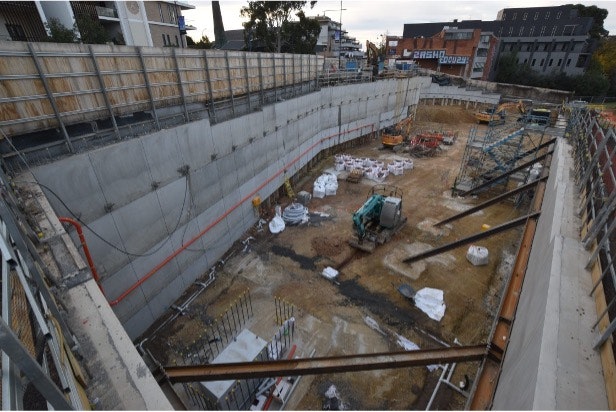

- In the Basement Levels 2 and 3, all formwork has been removed, blockwork walls have been constructed and services rough-in is underway.

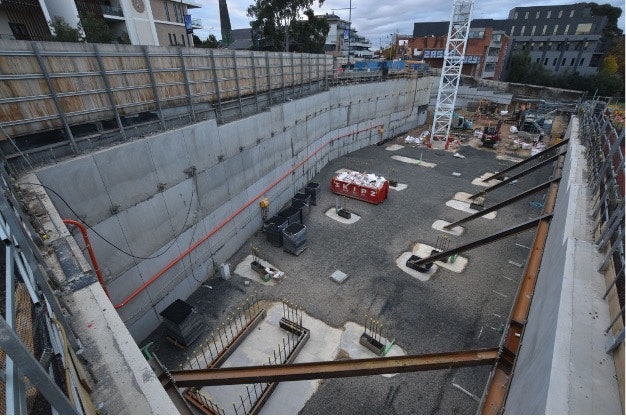

- In the Basement Level 1, formwork has been stripped and the slab is partially back propped.
End of December 2025 Forecast Milestones:
We expect to achieve several key milestones scheduled for completion in Q4 2025:
- Structure complete - L6/Roof concrete pour complete and Level 5 formwork stripped

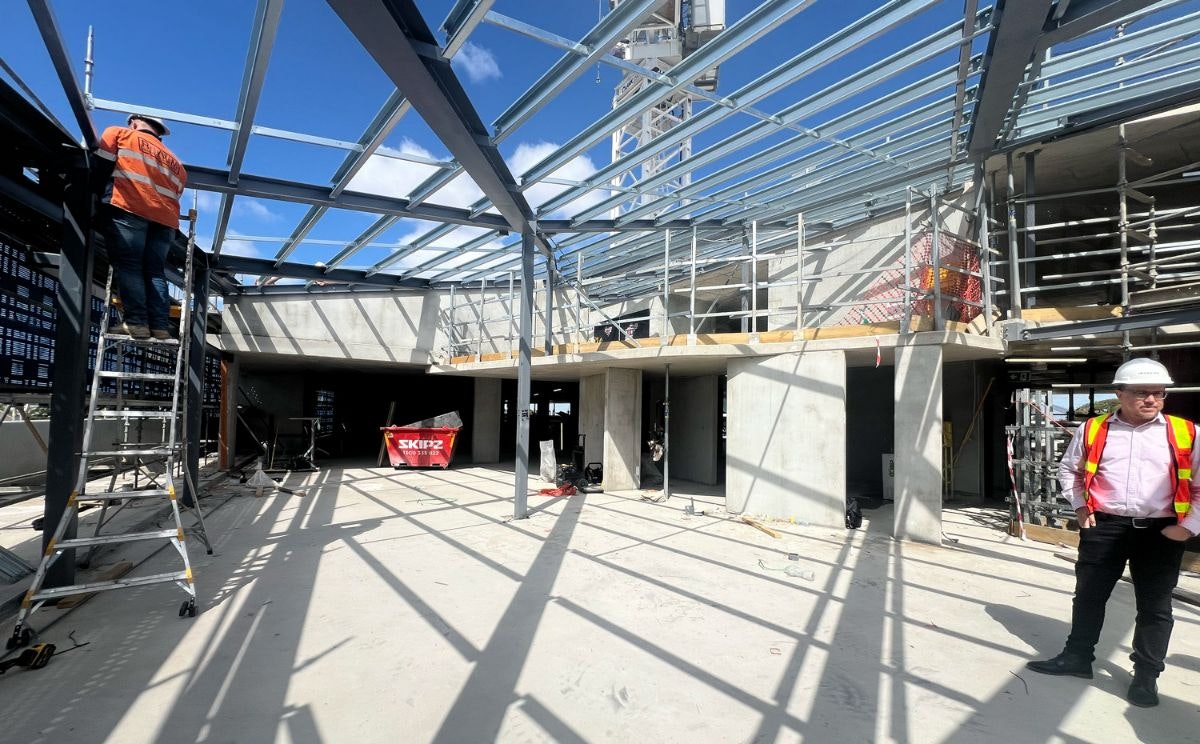

- Level 5 structural steel complete, Level 6 / roof structural steel complete and metal deck roofing commenced/underway
- Façade – Windows installed to ground floor and level 1
- Ground Floor - Plaster walls complete
- Level 1 - Framing and services wall rough-in complete
- Level 2 – Framing and high-level services rough in complete
- Level 3 – Setout for walls and install top track complete in preparation for framing
We will continue to share quarterly updates as construction progresses.
Thank you once again for your trust and support as we bring the Candela project to life.
Kind regards,
The Candela Design Team
